Skip to content

Step 3: Priority weighting

The final step deals with the Weighting priorities and Priority groups. These weights will be applied when the user starts running the scenario. An example is shown in Figure 1.

  • Weight values range from 0 to 5, and affect how important a Priority Weighting Layer (PWL) is compared to other layers.
  • A value of 0 indicates that the PWL has a lower importance.

  • A value of 5 means that the PWL has a higher importance.

CPLUS step 3

Figure 1: Step 3 allows the user to set the weights of each Priority Group

Priority Groups

The Priority groups are used to assign weights to specific PWLs based on their importance. These PWLs are subsequently applied during the weighting of NCS pathways when creating a scenario analysis.

Add priority groups

To add a new priority group, the user must click on the add button button, as shown in Figure 1.

This will open a Priority Group Dialog box, where user required to fill the following information.

  • Group name: Name of the group.
  • Group description: Description of the group.
  • Group value: Numeric value that reflect the importance of the priority layer.
  • Assign priority layers: This allows users to allocate importance values to different PWLs.

    • To assign a priority layer, click on the Assign priority layers and select from the available PWLs in the list.(see Figure 3)

Priority Dialog

Figure 2: Priority Group Dialog

After filling in the required information, click on the OK button to add it to the Priority groups.

Assign Priority Layer

Figure 3: Assign priority layers

Edit group layer

Select the layer and click on the edit button icon. This will open the Priority Group Dialog, allowing you to edit the group name, group description, group value, and assign new priority layers.

Priority Dialog

Figure 4: Priority Group Dialog Edit

Click OK to apply the changes.

Remove group layer

Select the layer and click on the remove button to remove the layer from the priority group.

Prority Weighting Layers

The priority weighting layers can be selected, added and removed into each priority group by using the arrow buttons.

Add priority layers

Select the target layer from the priority weighting layers list and the destination group from the priority groups and use the left arrow button left arrow to add the layer to the group.

Remove priority layers

Select the target layer from the priority weighting layers list from its priority group and use the right arrow button right arrow to remove the layer to the group.

Create custom priority layers

  • Click on add button to add a new custom priority layer, or edit button to edit an existing priority layer.

  • This will open the Priority Layer dialog (see Figure 5).

Methods to create layers

Method 1: Create manually

  • The following parameters need to be set:

    • Priority layer: The layer that represents the priority layer.
    • Priority layer name: A unique identifier for the priority layer.
    • Priority layer description: A detailed description of the priority layer.
  • Click the Assign NCS Pathways button to select NCS pathways to be associated with the priority layer (see Figure 5)

Priority layer editing/adding dialog

Figure 5: Priority layer dialog

  • Select the NCS pathways you want to be associated with the priority layer (see Figure 6).

  • Click OK.

Priority layer editing/adding dialog

Figure 6: NCS pathway selection for priority layers

Method 2: Create Online

Priority layer editing/adding dialog

  • After clicking on this option a drop down menu will appear with the available online defaults.

Priority layer editing/adding dialog

  • Select the desired online default.

Priority layer editing/adding dialog

  • Select the applicable NCS pathways, then click on the 1️⃣ OK button, to create the PWL.

  • Click the Remove PWL button remove button to remove one or more of the selected PWLs from the list.

NCS Pathways/PWLs Matrix of Relative Impact Values

The NCS Pathways/PWLs Matrix of Relative Impact Values is used to assign impact coefficients to describe how each pathway influences each Priority Weighting Layer (PWL). These coefficients range from –3 to +3 and are evaluated separately from the PWL weightings.

The system also clearly distinguishes between impact-based and fragmentation-based PWLs, ensuring that the correct type of coefficient is applied during evaluation.

Opening the Matrix Manager

To open the Matrix of Relative Impact Values Manager, first ensure that a Priority Weighting Layer is selected.

  1. Use the add button button to add a new custom priority layer.

  2. Select a layer from the Priority Weighted Layers panel.

  3. Click the Create Matrix of Relative Impact Values for Priority Weighted Layer button to open the manager.

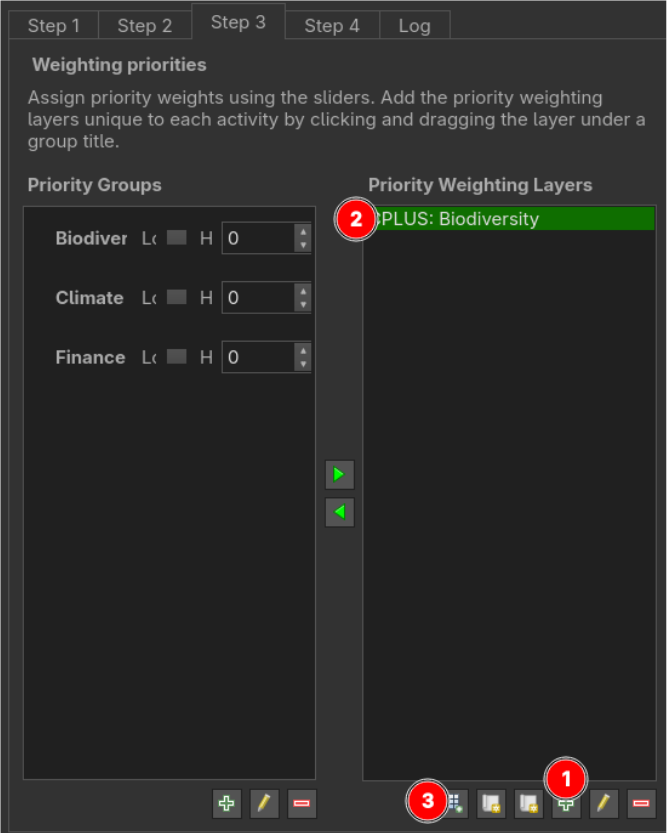

Opening Matrix Manager

Assigning Impact Coefficients

In the Matrix Manager, each pathway and PWL pair is represented in a table. Enter an impact coefficient between –3 and +3 to indicate the relative influence of that pathway on the selected PWL.

These coefficients are stored and used during model evaluation alongside, but independently from, the weighting values applied to PWLs.

Matrix of Relative Impact Values Manager

NCS Pathways Matrix of Relative Impact Values

Identifying Carbon Layers

Because layer names alone are not reliable indicators of carbon content, the interface includes a dedicated checkbox (1️⃣ Enable if layer has carbon storage values) that allows users to mark a layer as containing carbon storage or carbon impact values.

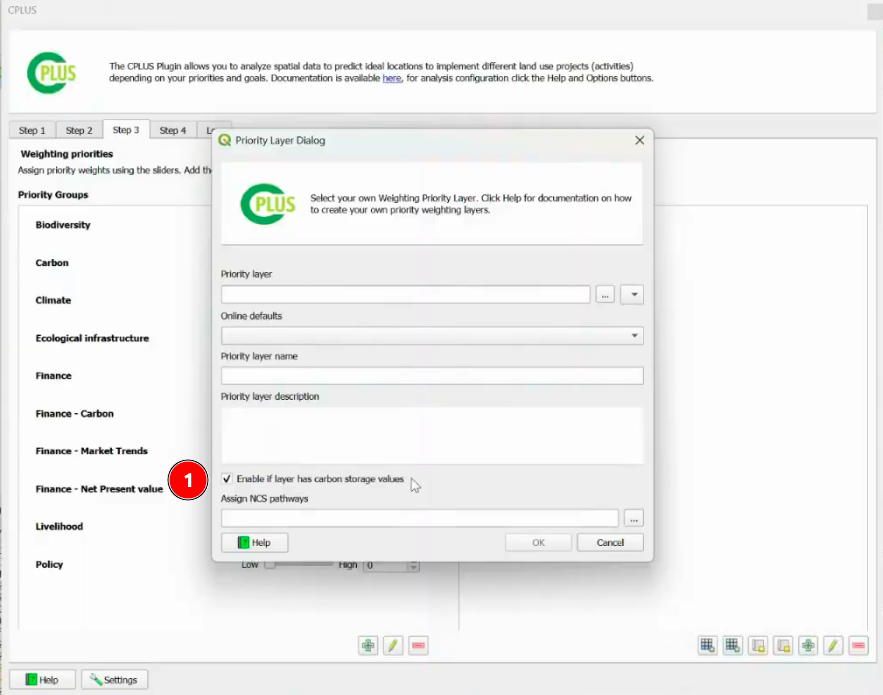

Enable if layer has carbon storage values checkbox

Once selected, the layer is treated as a carbon layer during prioritisation and is automatically added to the carbon-specific tab within the interface. Layers not marked as carbon layers are listed instead in the general impact matrix.

Opening the Matrix Manager

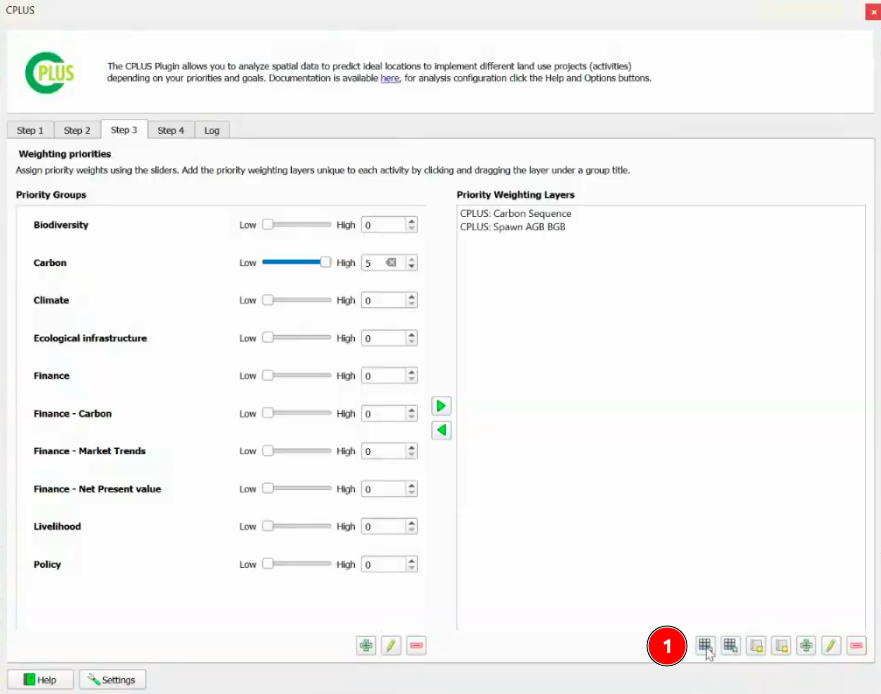

To open the NCS Pathways Matrix of Relative Impact Values Manager, click the 1️⃣ Create Matrix of Relative Impact Values button to open the manager.

Create Matrix of Relative Impact Values

For each eligible pathway, the plugin converts the carbon calculation results into a carbon impact potential raster. This raster is normalised to a consistent scale so that it can be compared with other pathway-variable relationships.

At the top of the manager 2 tabs are available:

  1. Carbon Impact
  2. Priority Weighting Layers

NCS Pathways Matrix of Relative Impact Values Manager

Assigning Impact Values

Carbon layers use an impact weight range from –1 to +1, while non-carbon layers continue to use the –3 to +3 range. This separation ensures that carbon values remain proportionate without overwhelming other prioritisation factors.

  1. Navigate to the Carbon Impact tab.

  2. Enter a Carbon Impact Rating (–1 to +1) for each NCS Pathway.

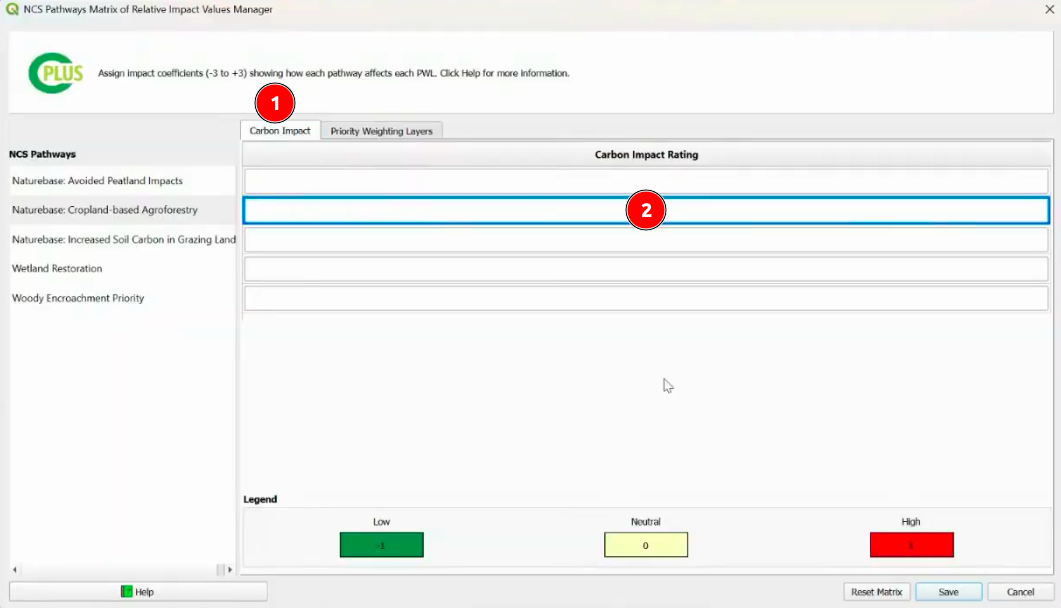

Carbon Impact Tab

  1. Navigate to the Priority Weighting Layers tab.

  2. Enter an impact coefficient (–3 to +3) for each NCS Pathway and PWL combination.

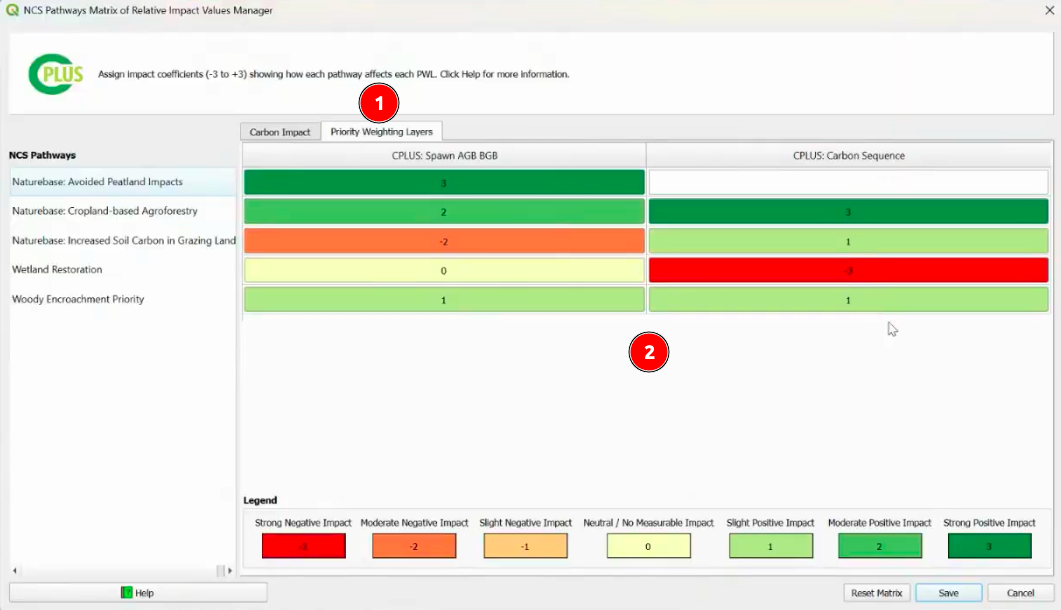

Priority Weighting Layers Tab

Create a Net Present Value (NPV)

The plugin supports adding additional investability factors, such as years of project experience, by allowing users to incorporate constant raster layers into their analysis.

Users can create or load constant raster layers representing custom variables. The plugin automatically normalizes these values, typically scaling them between 0 and 1 so they contribute consistently alongside other metrics.

Opening the Manager

Click on the File image icon to open the Investability Variable Manager.

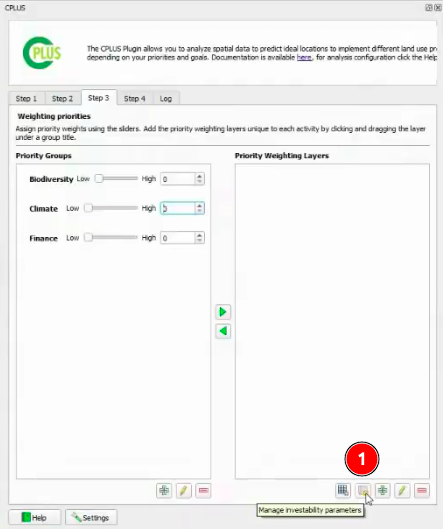

Investability Variable Manager Button

Adding a Net Present Value (NPV)

  1. From the Investibility Type dropdown select Net Present Value.

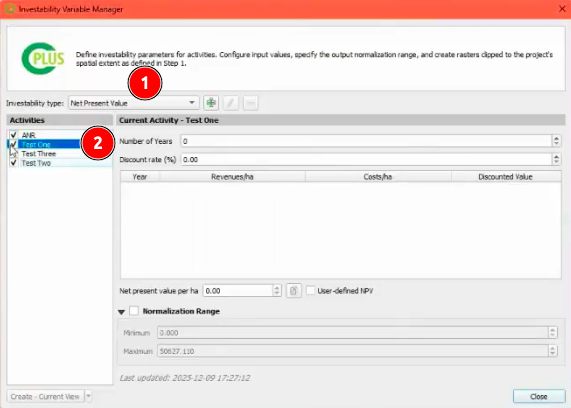

  2. Select an Activity to open its coresponding configuration.

Add NPV

  1. Enter the Number of Years and Discount Rate.

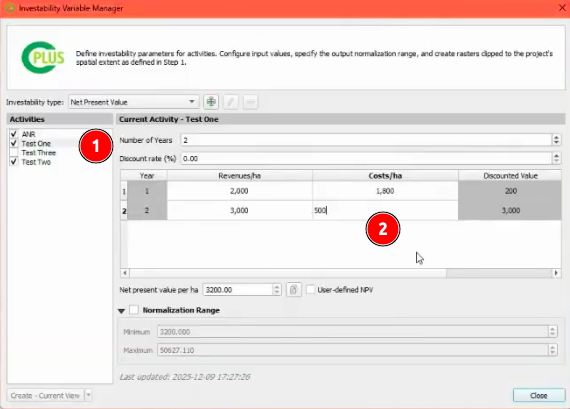

  2. Input the Revenue and Cost values for the respective years.

Add Variables

Adding Custom Investability Variables

Users have the ability to add a new investability variable besides NPV and years experience.

  1. Click the Add New Investability Type button.

  2. Provide a Name for your investabilty type.

  3. Define the Normalization Range values.

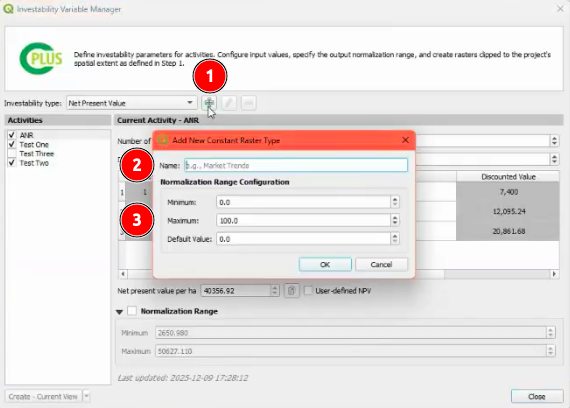

Add Variables

Setting groups values

Move the slider to adjust the weight of each group, values can also be set manually, by using the left input spin box.

Click here to explore the step 4 section.

Click here to explore the log section.
